Skip to Main Content

The California High-Speed Rail Authority (Authority), local and state leaders celebrated the completion of the Tulare Street Grade Separation project with a ribbon cutting ceremony in Fresno’s Historic Chinatown. Located near the future site of the nation’s first high-speed rail station, the grade separation reconnects Fresno’s historic Chinatown and downtown, while improving safety and reducing greenhouse gas emissions and unhealthy pollutants.



The Tulare Street underpass and grade separation project, constructed by Tutor-Perini/Zachry/Parsons, is located between G and H streets, between downtown and Fresno’s Chinatown. The grade separation now takes vehicular traffic more than 20 feet below the Union Pacific and future high-speed rail tracks. It serves as a two-lane roadway spanning more than 1,000 feet long and 60 feet wide, with pedestrian access and bike lanes for residents and bicyclists.

Updates Per Project

Tulare Street Underpass (drone view)

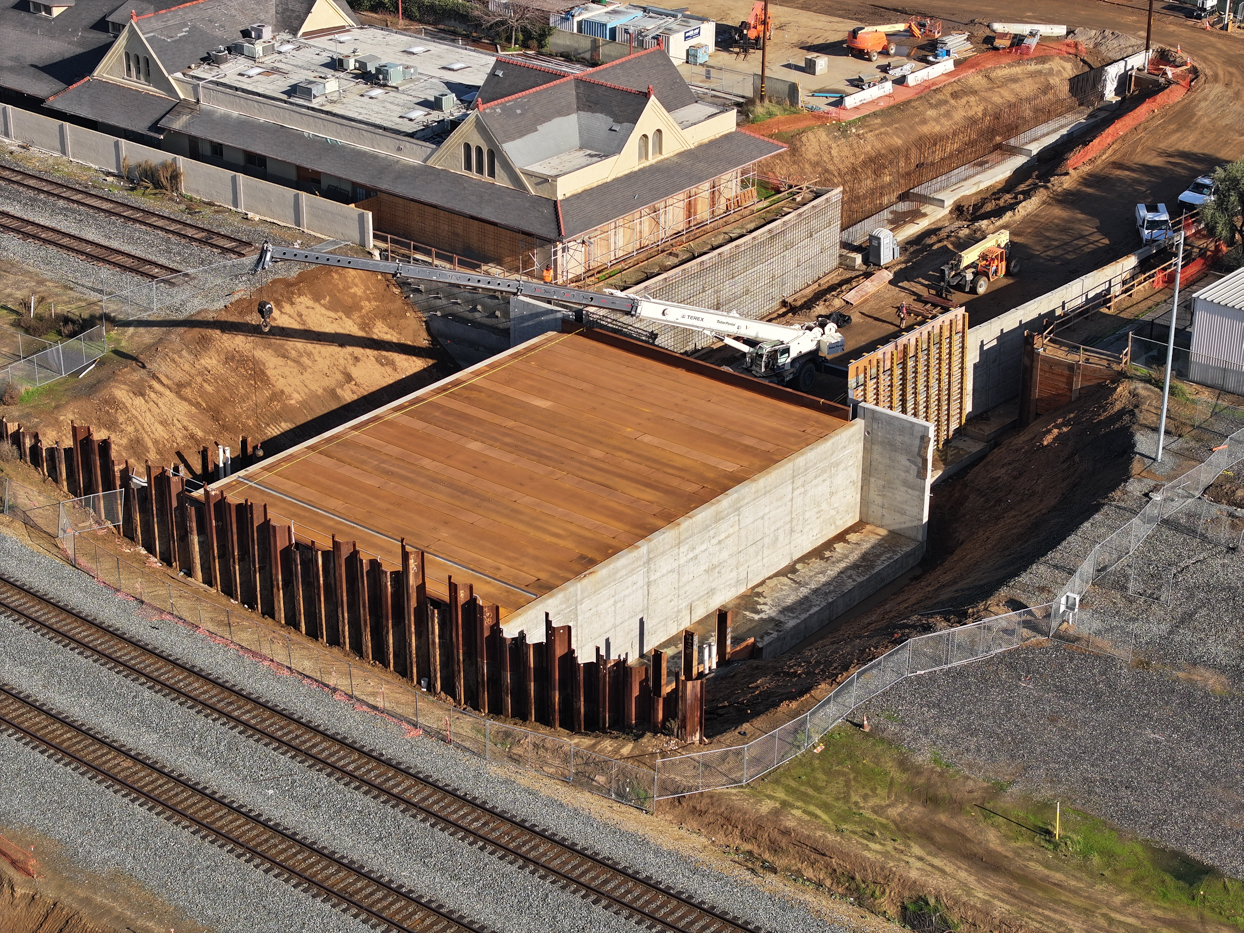

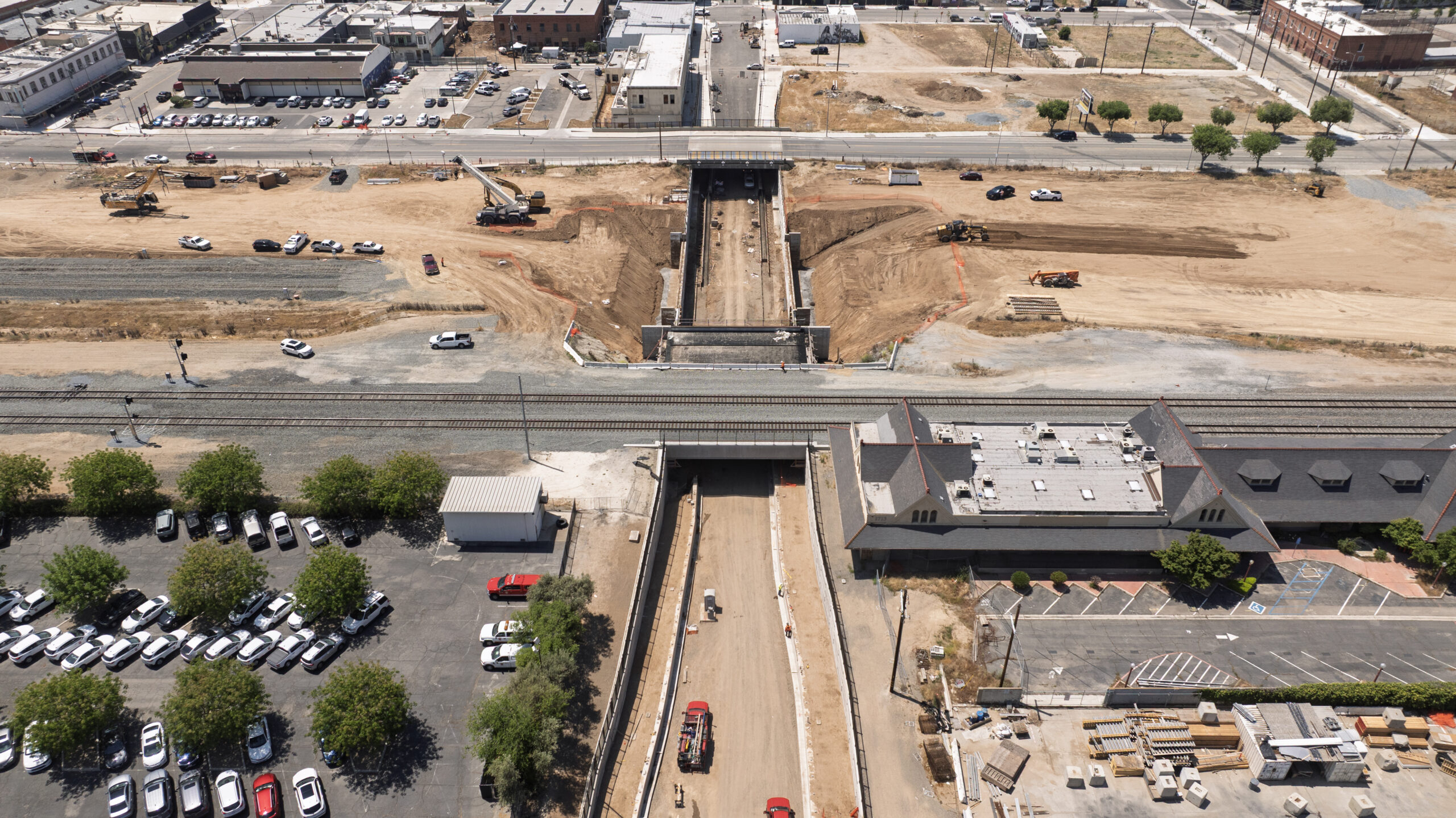

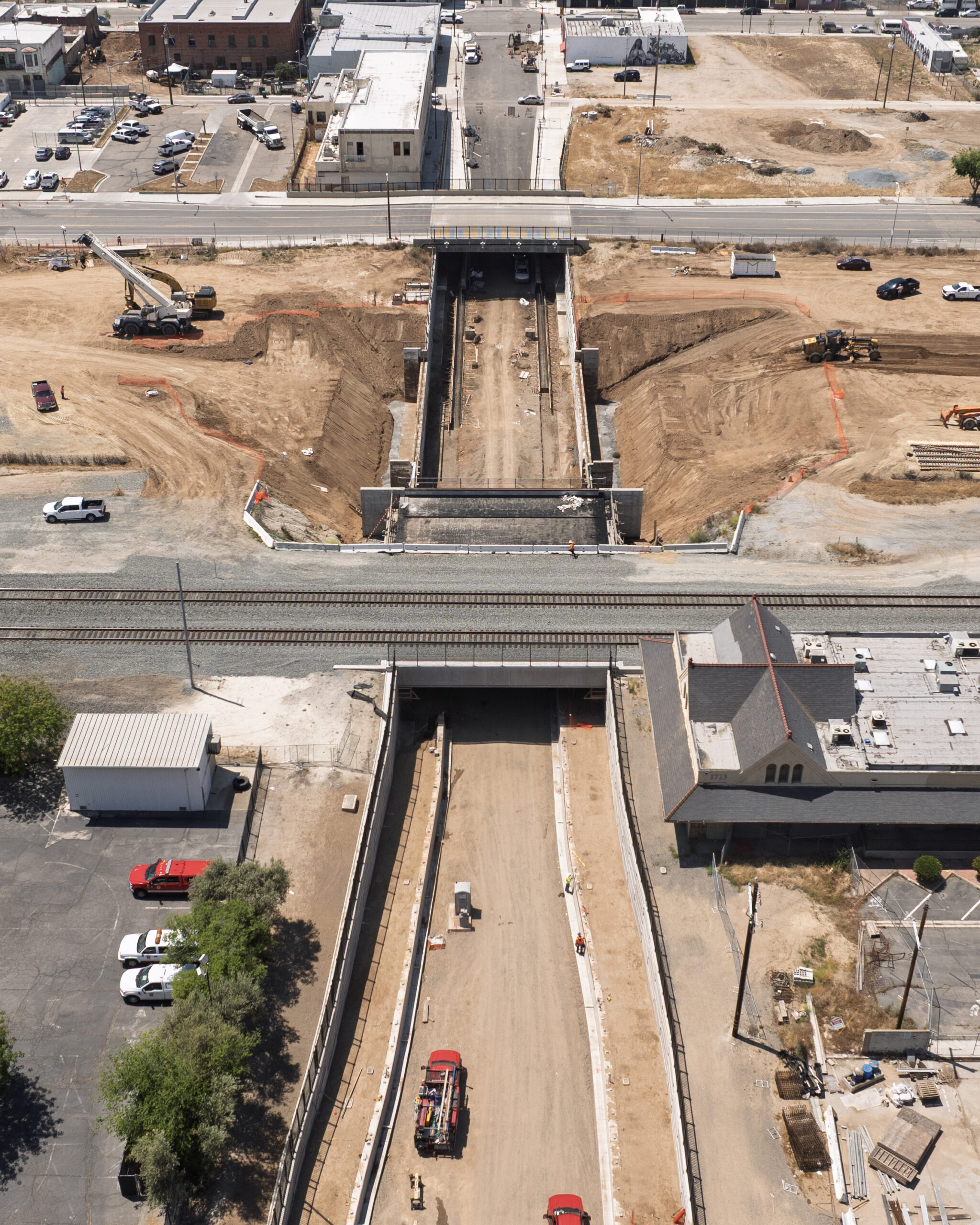

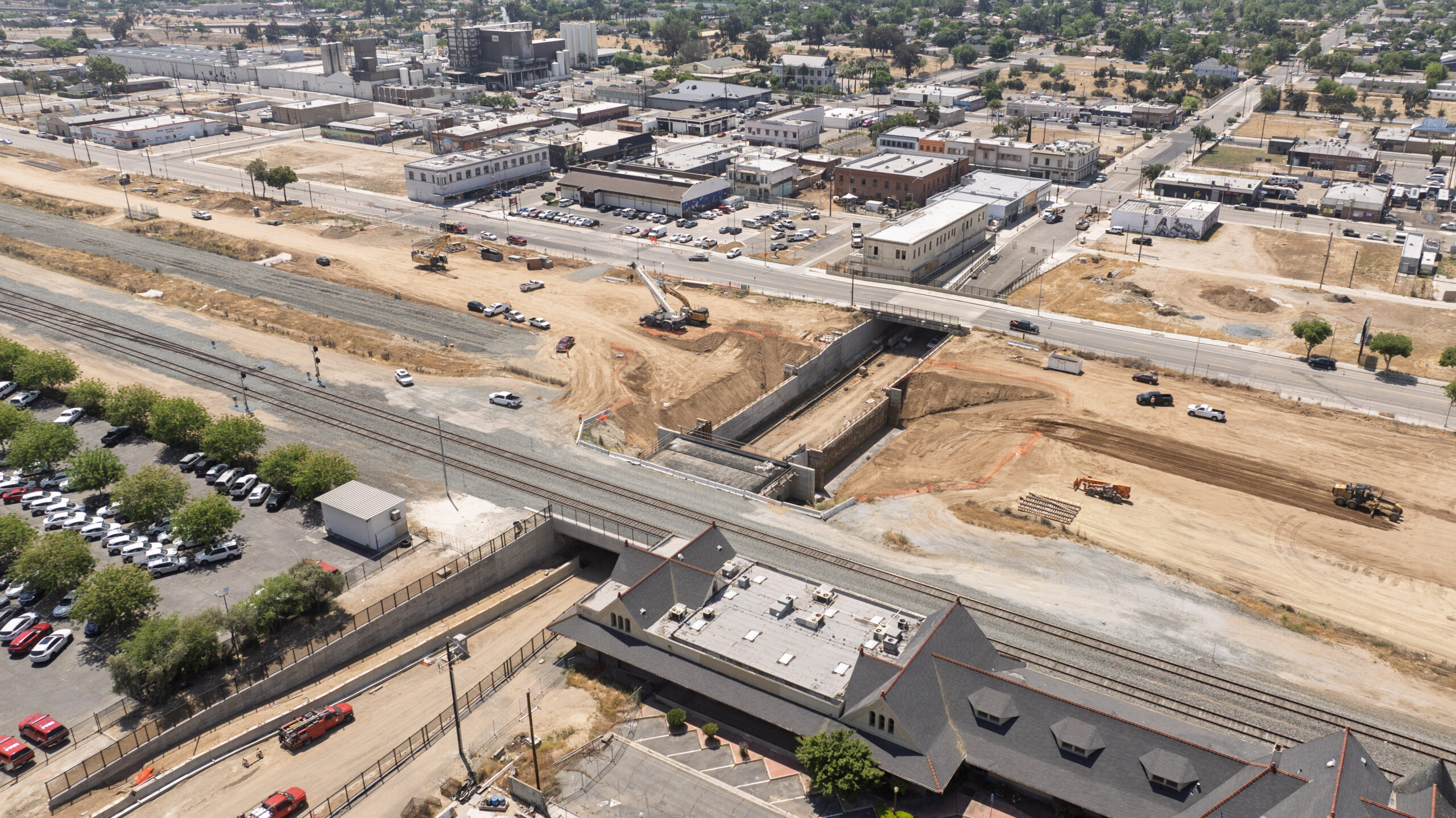

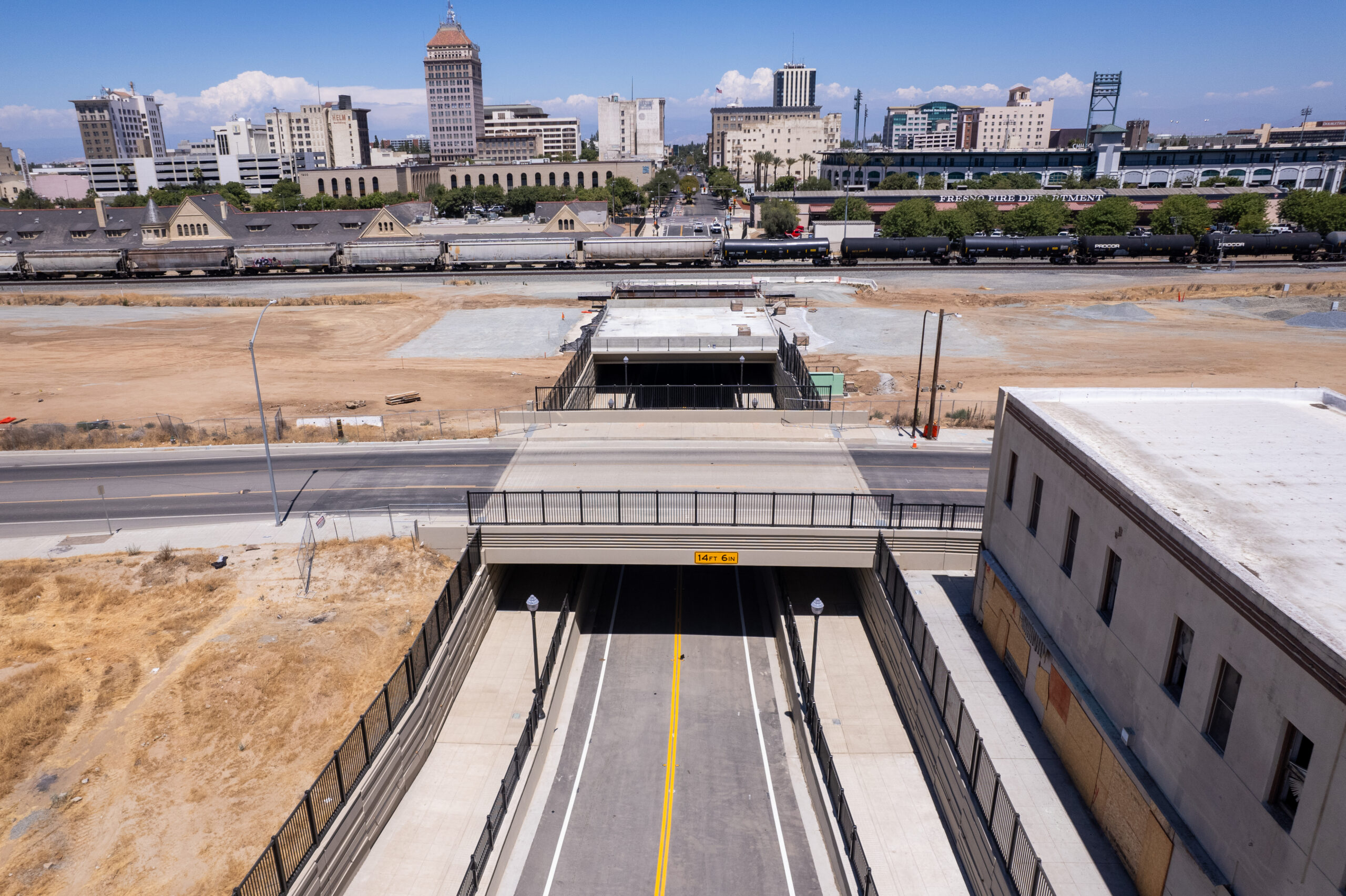

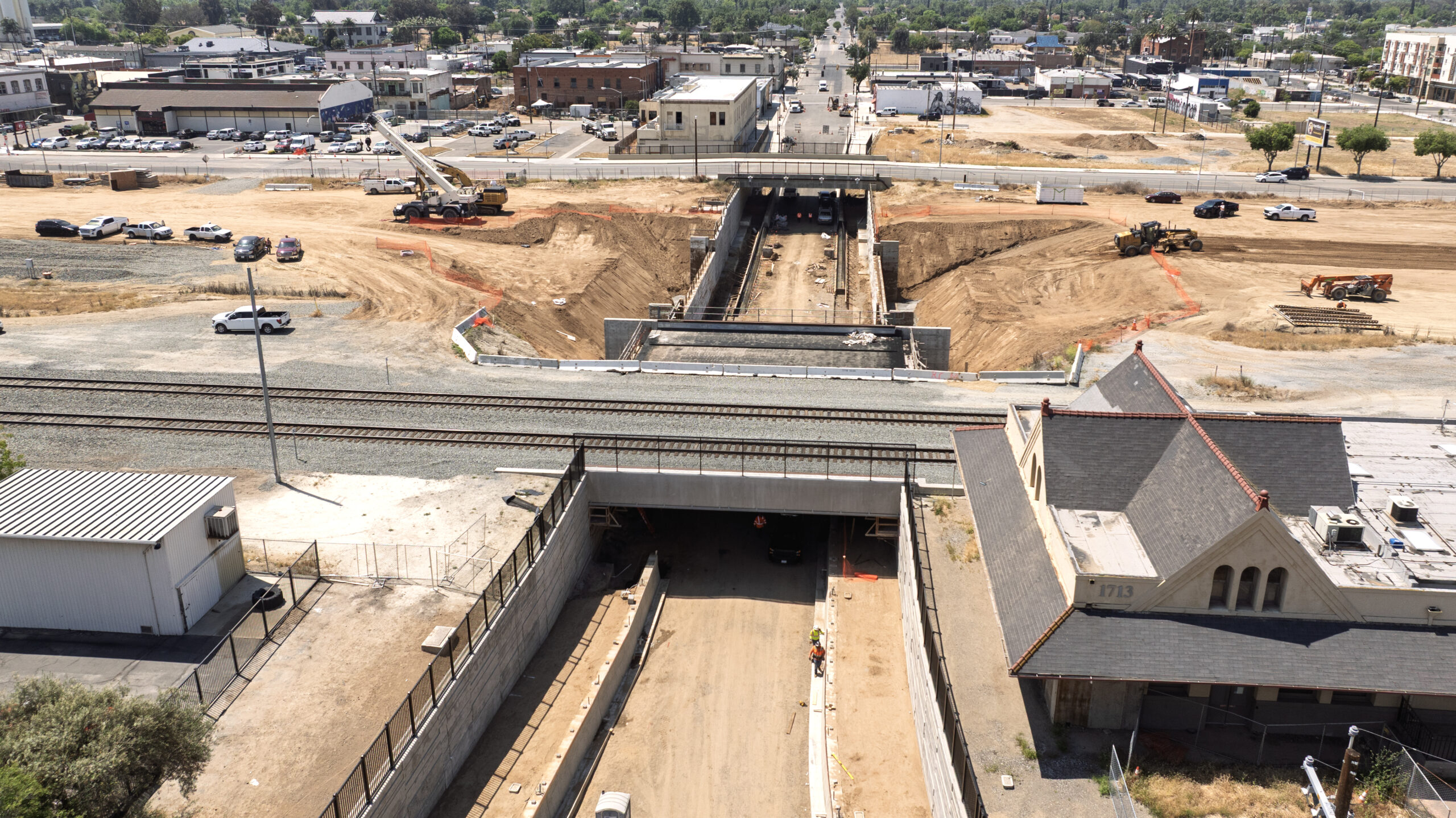

May 21, 2025

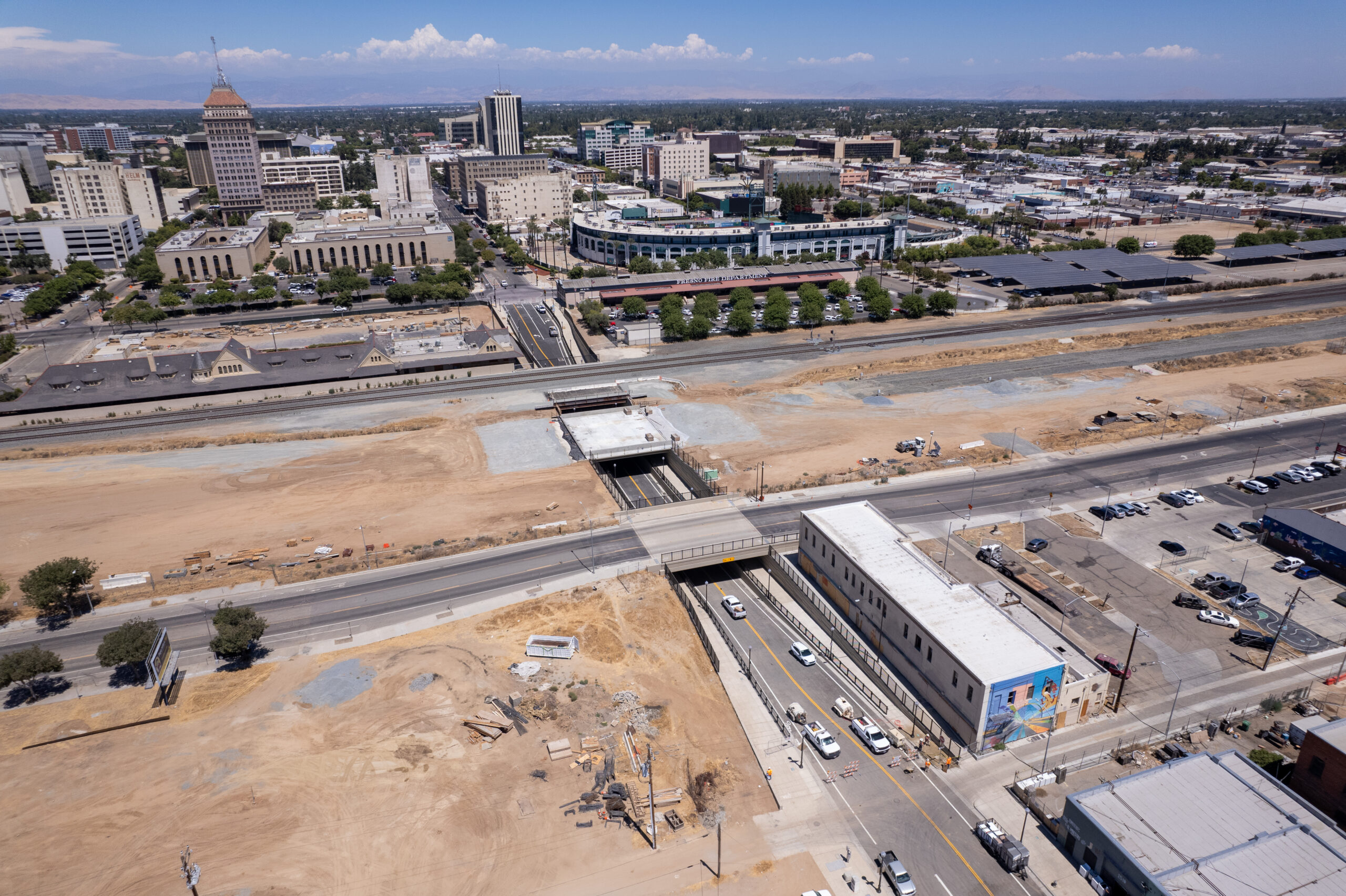

Near downtown Fresno, the Tulare Street Underpass continues to take shape. Crews have tied rebar and poured concrete to form the remaining retaining walls of the underpass. Mass excavation for the underpass has been completed, clearing the remaining soil necessary for the roadway construction that will connect downtown Fresno with Chinatown. Recently, all 14 girders needed for the second bridge were also placed over the underpass, which will allow high-speed trains to cross over the roadway.  Crews are now working on the gravity walls, sidewalks, and streetlights for the underpass. The Tulare Street Underpass is expected to be completed and open to traffic this summer.

Tulare Street Undercrossing (drone view)

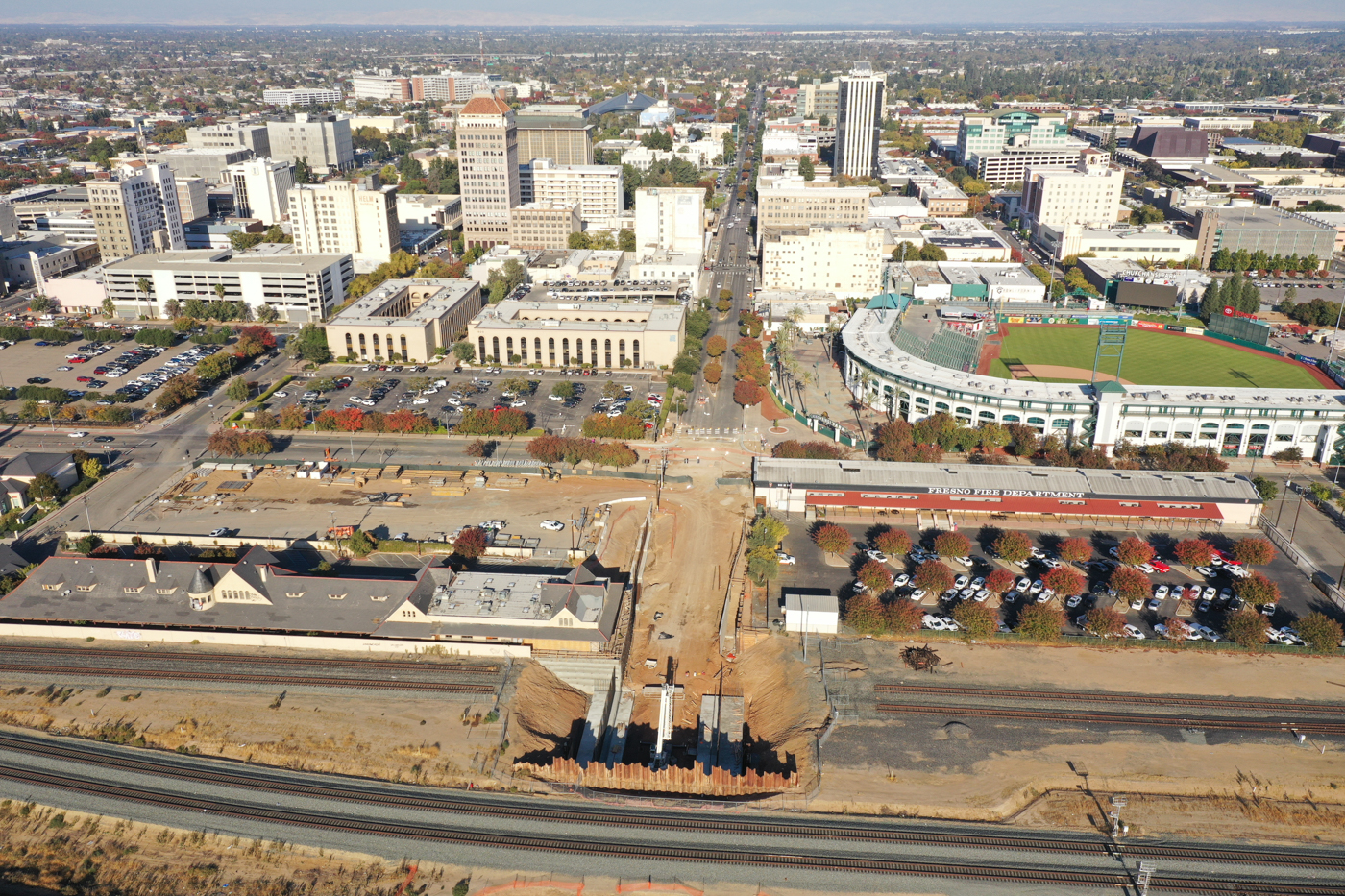

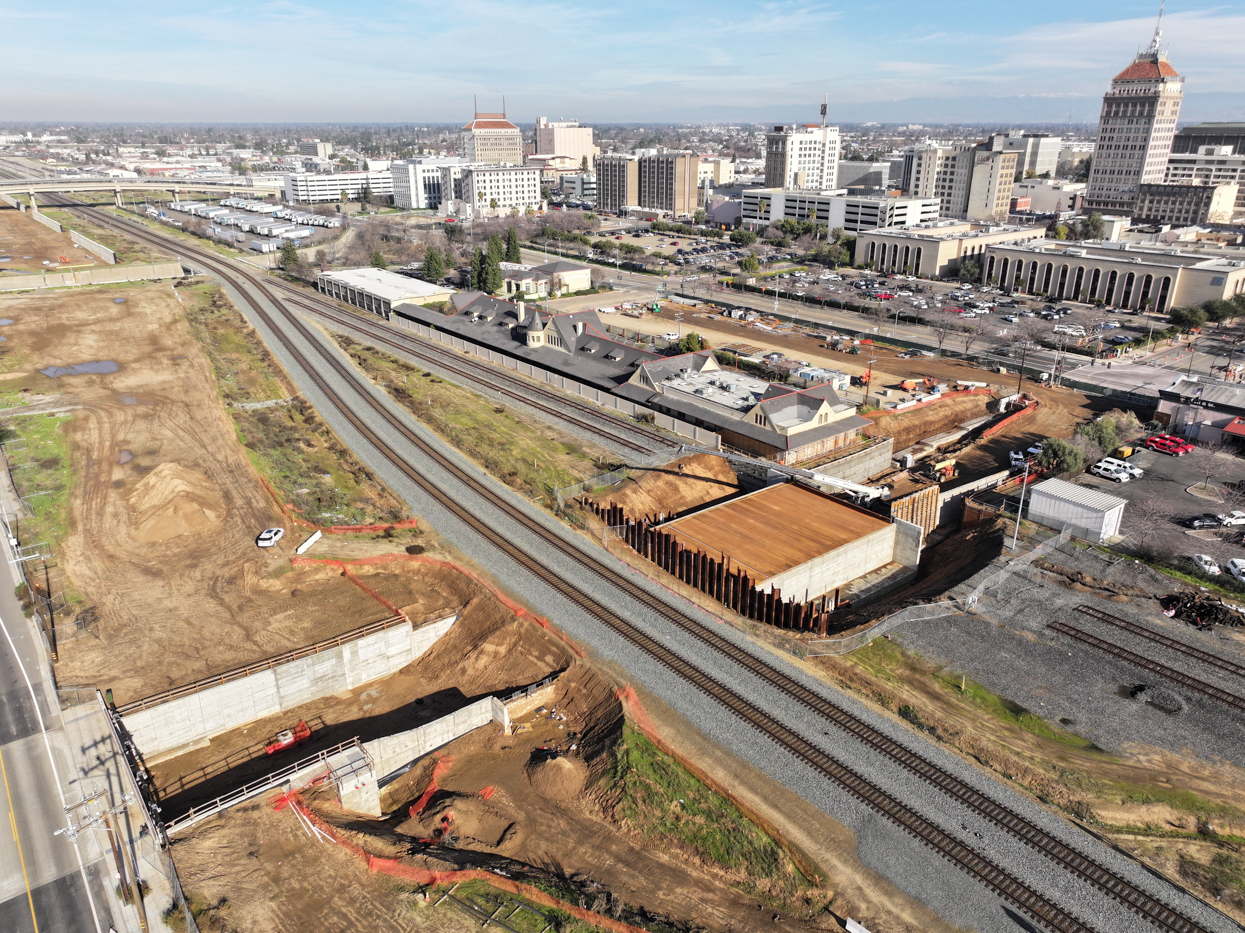

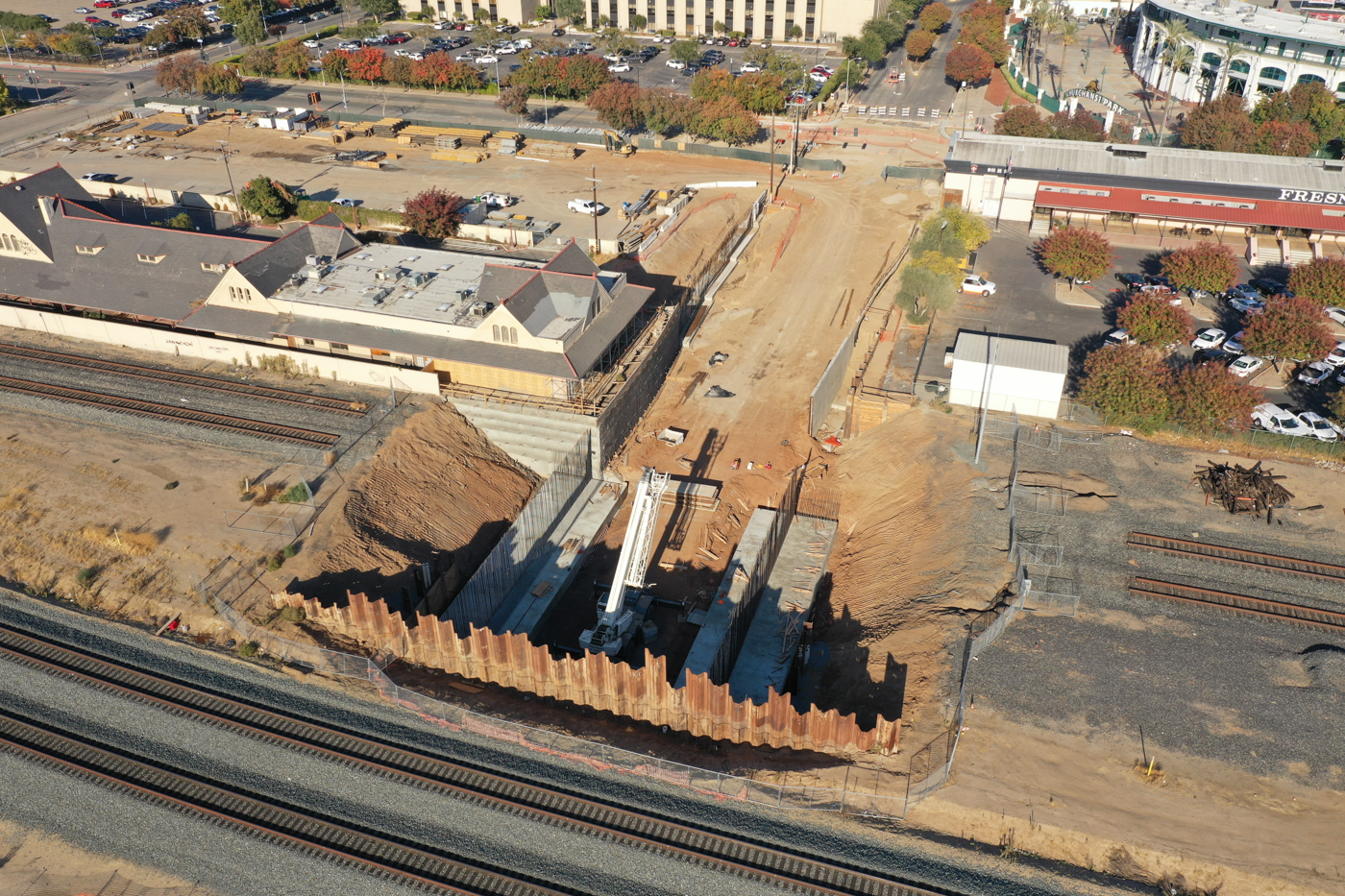

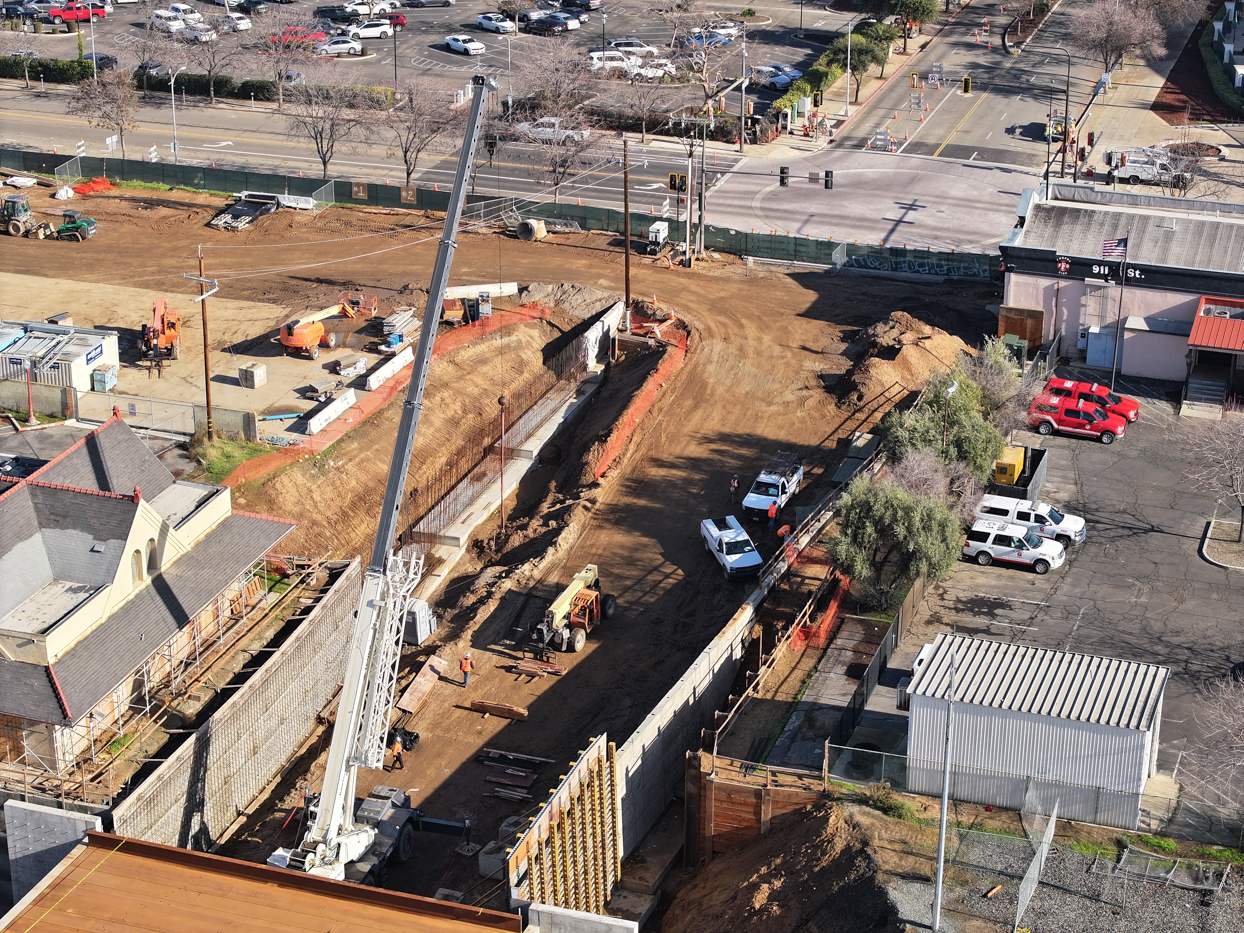

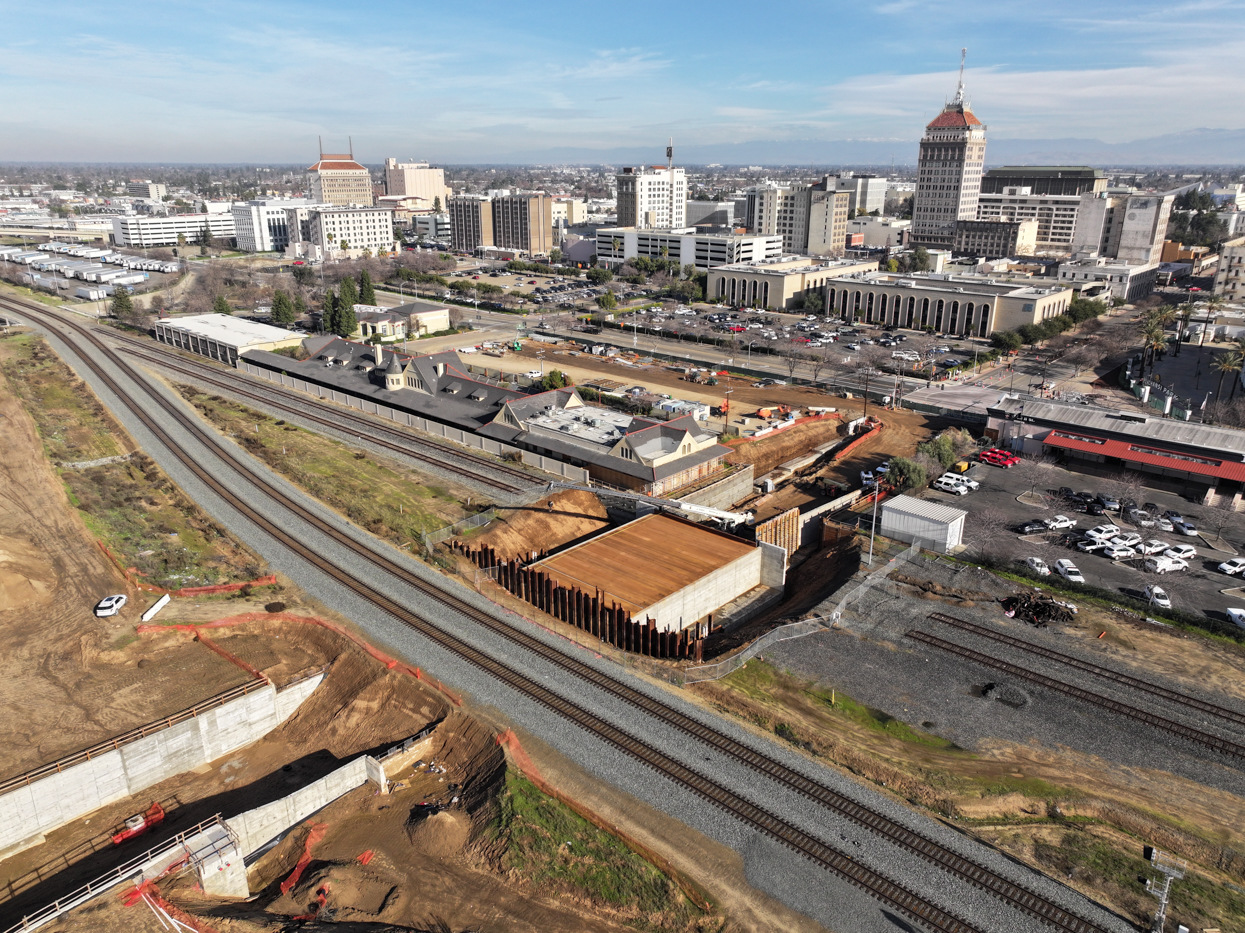

May 21, 2024

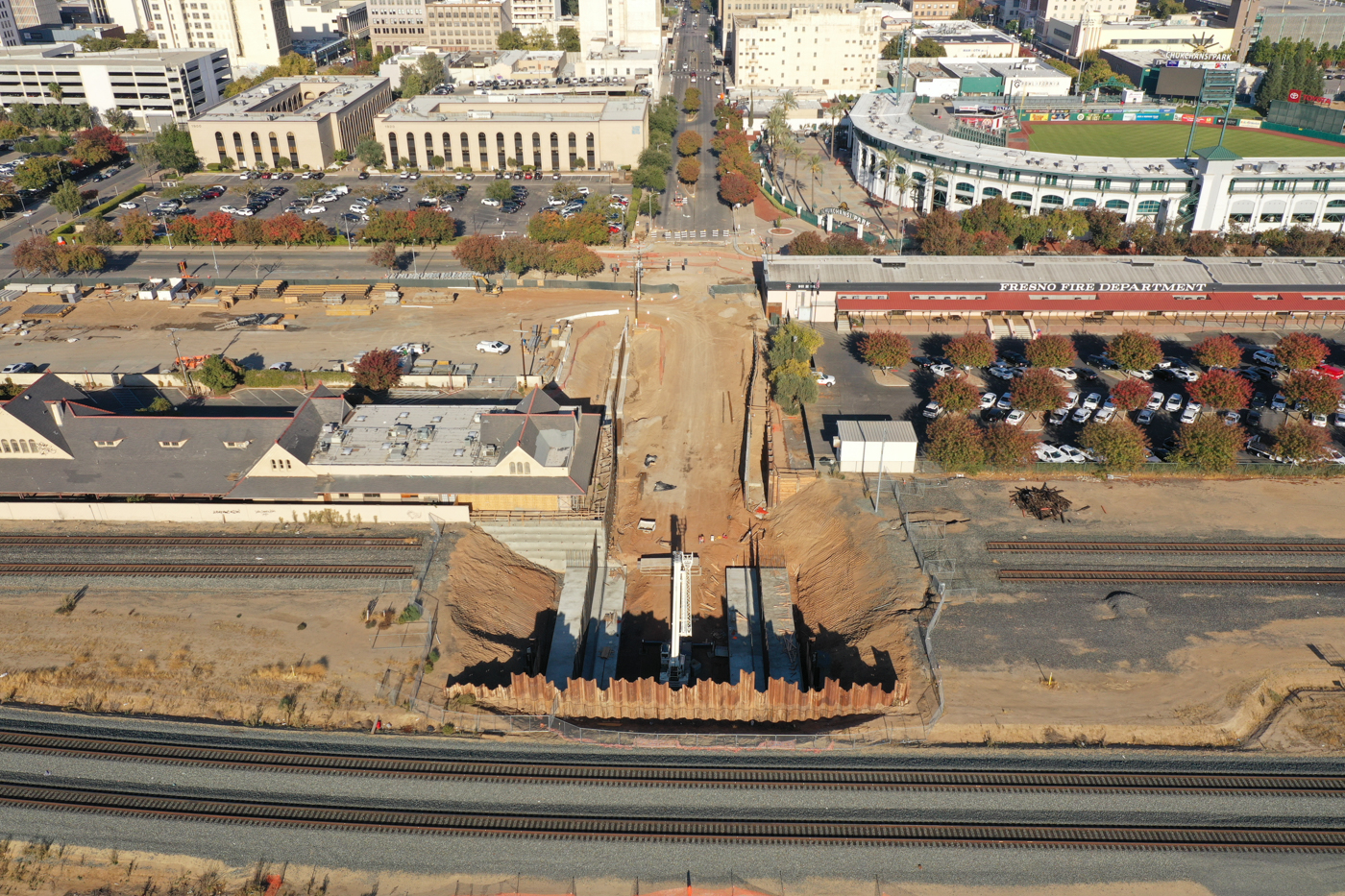

On the east side of the Tulare Street Undercrossing, crews have completed installing soil nails below the Historic Train Depot, the future location of the Fresno Station. Soil nails will help stabilize the earth below the building as crews continue work on the retaining walls. Concrete has also been placed on portions of the retaining walls on both sides of the structure. Roadwork improvements have also begun at the intersection of Tulare and H streets. Work will include reconstruction of the existing intersection to tie in with the future grade separation

Tulare Street Undercrossing (drone view)

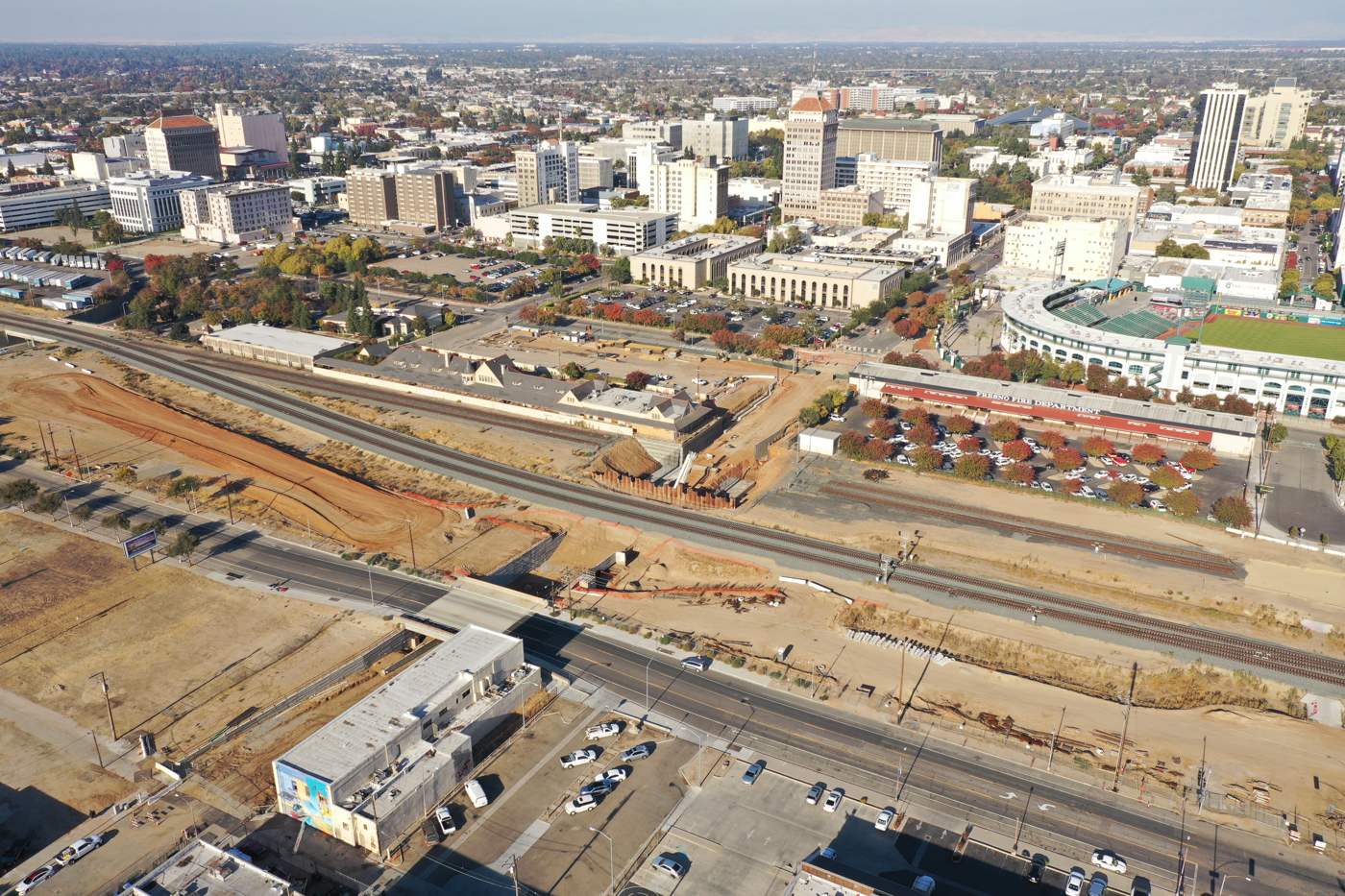

May 10, 2023

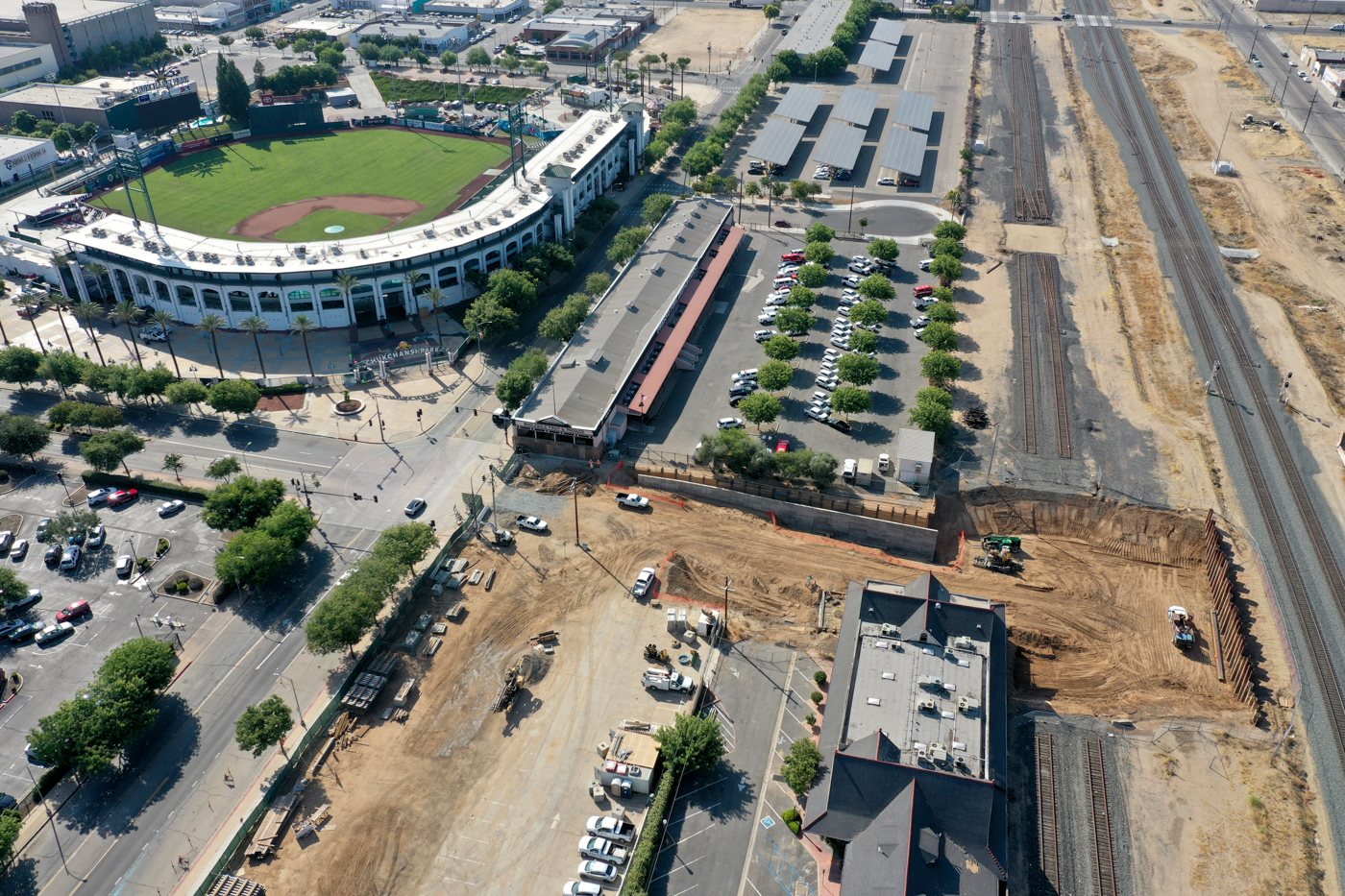

Crews are now working on the east side of the Tulare Street Underpass. Crews have removed utilities in the area and continue to excavate dirt and install shoring – supports that help prevent the movement of soil – for the construction of the future underpass and new bridge for the Union Pacific railroad. Bridgework will begin in the coming months. In addition, and just slightly south, a new cul-de-sac was completed on Kern Street near Chuckchansi Park stadium parking, just in time for the Fresno Grizzlies baseball season.

Tulare Street Undercrossing (drone view)

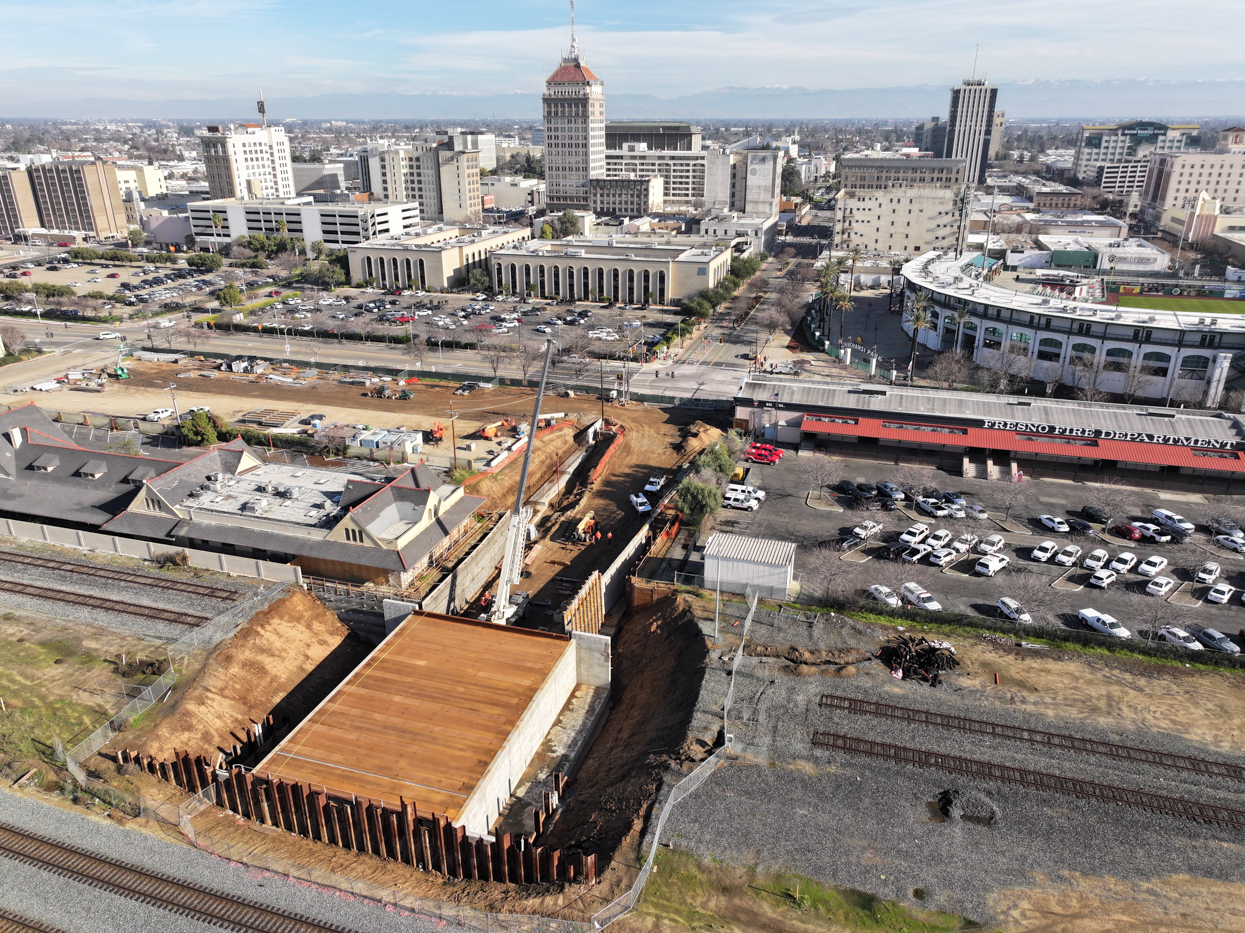

November 1, 2022

Progress continues at the Tulare Street Underpass between downtown Fresno and Fresno’s Chinatown. The G Street bridge is nearly completed. Post-tensioning of the bridge has been completed, falsework has been removed, and the concrete to form the barrier and sidewalk has been placed. Crews are now putting the finishing touches, including paving and installing streetlights, on the bridge for traffic. The G Street bridge should be open to the public soon. When complete, the Tulare Street Underpass will be 22 feet below grade and will include pedestrian access.

Tulare Street Bridge March 2022

June 1, 2022

Between downtown and Fresno’s Chinatown, progress continues on the Tulare Street Underpass. The G Street bridge is nearly completed. Post-tensioning of the bridge has been completed, falsework has been removed, and the concrete to form the barrier and sidewalk has been placed. Crews are now putting the finishing touches, including paving and installing streetlights on the bridge for traffic. The G Street Bridge should be open to the public soon.

March 1, 2022

Between downtown and Fresno’s Chinatown, progress continues on the Tulare Street underpass. Both tracks of the Union Pacific railroad have been cutover to the shoofly, a temporary track built for the construction of the grade separation. Also, the west approach retaining walls and excavation under G Street is now complete. Crews have also installed the falsework for the G Street Bridge, placed concrete to form the bridge deck, and are now preparing to begin post-tensioning the ducts inside the bridge deck.

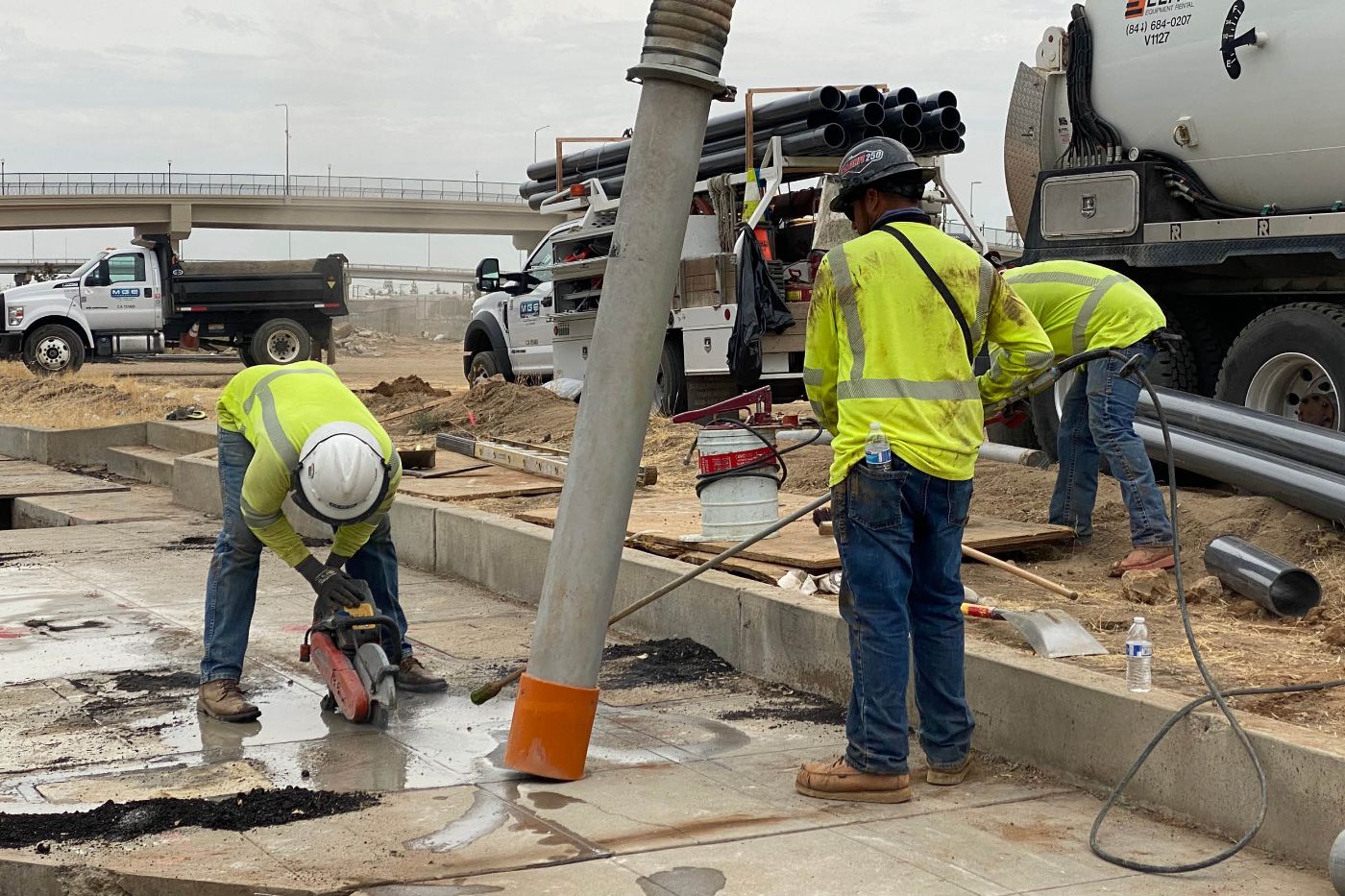

September 29, 2020

There is plenty of work happening just west of downtown Fresno and the future high-speed rail station. At Tulare and G Street, crews are relocating a telecommunications line near the future high-speed rail undercrossing. Crews are also relocating electrical utilities at Mono and G Street, and at Fresno and G Street in preparation for future construction.
