On July 31, 2019, the California High-Speed Rail Authority and its design-build contractor Tutor-Perini/Zachry/Parsons (TPZP) opened two newly constructed overpasses on Avenue 8 and Avenue 11 in Madera County that allow traffic to travel over the high-speed rail system. This marks the first completed high-speed rail grade separations for Madera County.

“The completion of this overcrossing is a great step forward toward a positive working relationship with High-Speed Rail and Madera County,” said Brett Frazier, Madera County Supervisor. “We see the benefits of this and other projects in Madera County and are working closely with High-Speed Rail to collaborate and effect a mutually beneficial solution to any present and future construction jobs. This increased level of collaboration is essential to minimizing impacts to the residents of Madera County and the opening of all other roads impacted by construction.”

At Avenue 8, the overpass is located between State Route 99 and Road 33 and is over 110 feet long, 34 feet wide and reaches 44 feet at its highest point. The Avenue 11 overpass, between Road 31 and Road 32, is over 100 feet long, 34 feet wide and reaches 43 feet at its highest point.

“Today’s re-opening of Avenues 8 and 11 is a significant milestone for the project as we continue to work on and complete several more grade separations within the community of Madera,” said Diana Gomez, Central Valley Regional Director. “High-Speed Rail is committed to building and delivering the Central Valley system as quickly and safely as possible.”

Several small businesses took part in constructing the new grade separations including Becho, Inc., Landavazo Bros., Inc. Martinez Steel Corporation, Oliveira Fence, Inc., McCormick Biological, Inc., Avison Construction, Inc., Con-Fab California, Valverde Construction, Inc. and Safety Striping Service, Inc.

This project is part of Construction Package 1, the first 29-mile construction area that stretches from Avenue 17 in Madera County to East American Avenue in Fresno County. There are currently 21 active construction sites from Madera to Kern counties, with more than 300 certified small businesses working to build the Central Valley segment. To date, nearly 3,000 construction workers have been dispatched to the project.

Feet Long

Feet Wide

Feet at the highest point

Updates Per Project

March 27, 2019

Recent cold temperatures and rain have held up final asphalt paving for the roadway leading up to the bridge at Avenue 11. While they wait for warmer paving weather, crews have begun working on the area under the bridge.

February 27, 2019

Though the bridge itself is largely complete, recent cold temperatures and rain have held up final asphalt paving for the roadway leading up to it. This crossing for Avenue 11, a little east of Road 30 ½, will take traffic over the high-speed train alignment in Madera County.

December 27, 2018

On the Avenue 11 bridge, crews are completing traffic barriers on the bridge. Next, dirt, paving, and guardrail crews will be mobilizing to complete the overpass, starting with the roadway leading up to the concrete bridge deck. A rock base will then be placed for the roadway followed by asphalt paving. This crossing, east of Road 30 ½, will take traffic over the high-speed train alignment.

November 24, 2018

At the Avenue 11 Grade Crossing, embankment and conduits for future utilities are being completed off the bridge. On the bridge, crews are currently constructing traffic barriers along the sides of the deck. Next, paving and guardrail subcontractors will mobilize to complete the overpass. This crossing, east of Road 30 ½, will take traffic over the high-speed train alignment in Madera County.

October 24, 2018

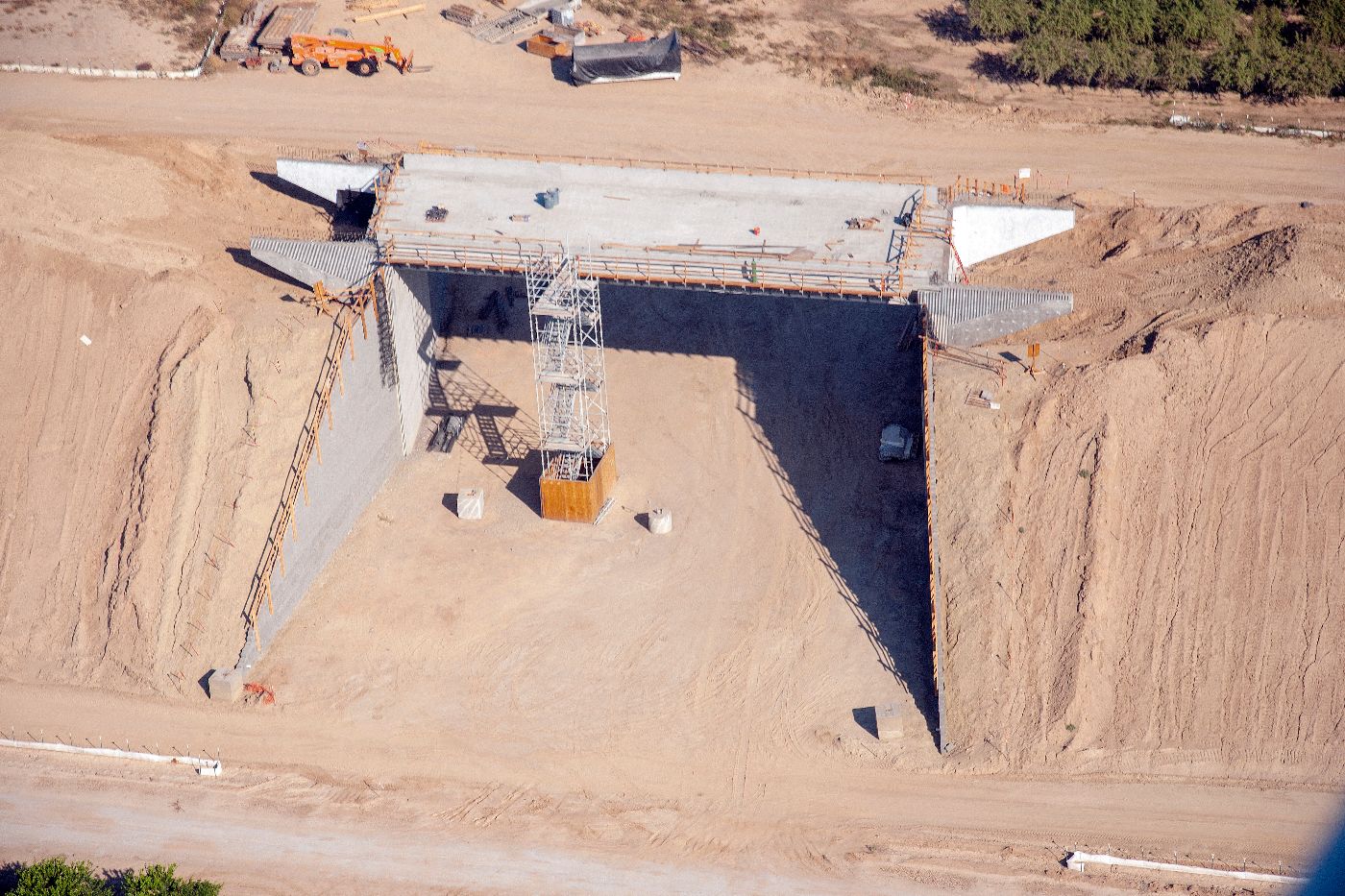

The concrete bridge deck for the Avenue 11 overcrossing has been poured and wing walls constructed along the sides that will tie the structure in with the embankment. Crews are currently constructing barrier walls along the sides of the deck and finishing wing walls which extend off the bridge. This crossing, east of Road 30 ½, will take traffic over the high-speed rail alignment in Madera County.

September 24, 2018

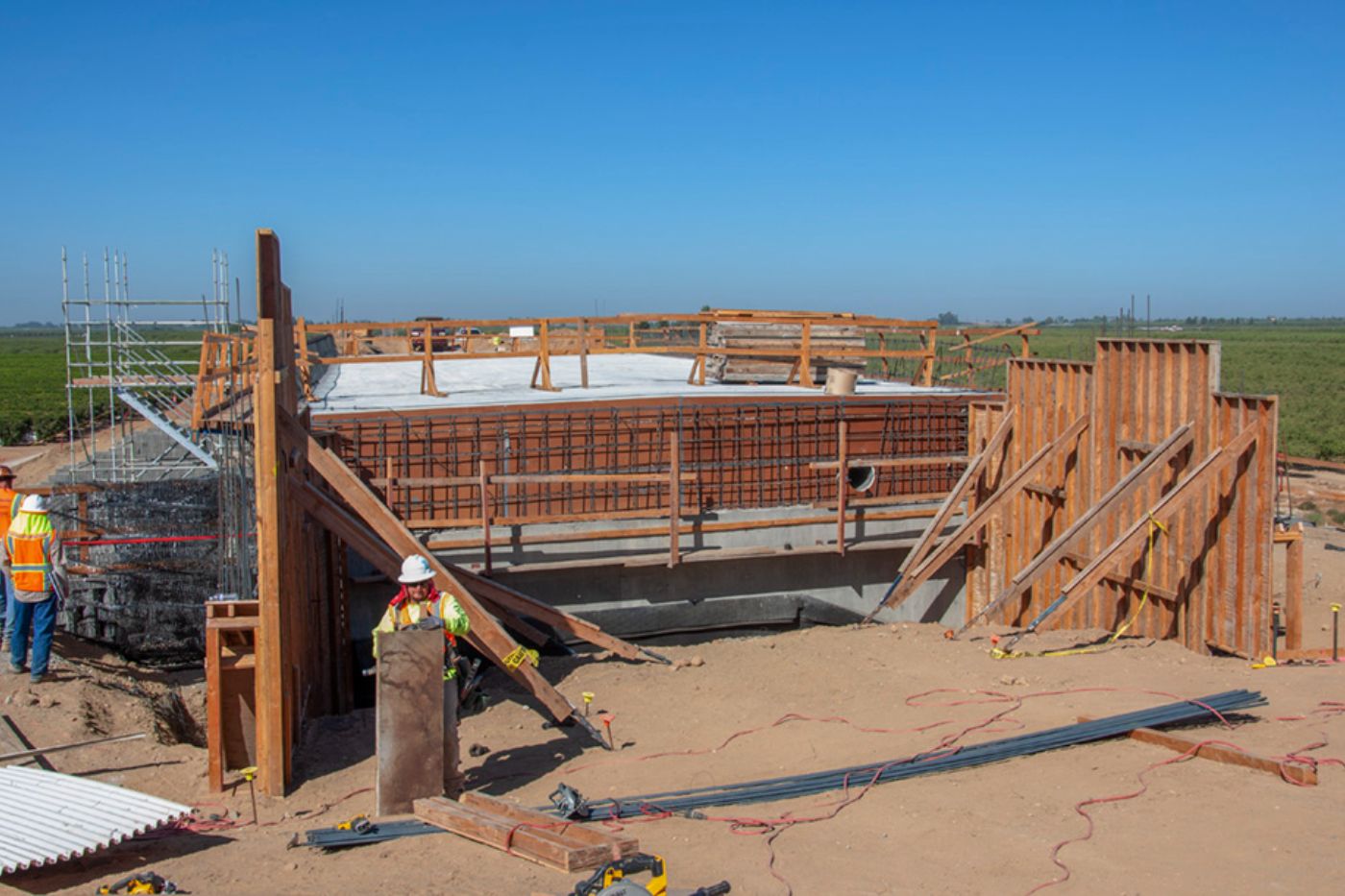

At the Avenue 11 overcrossing, concrete has been placed for the bridge deck. Next, crews will begin construction of wing walls and the approach slabs that will tie the structure in with the embankment. This crossing, east of Road 30 ½, will take traffic over the high-speed rail alignment in Madera County.

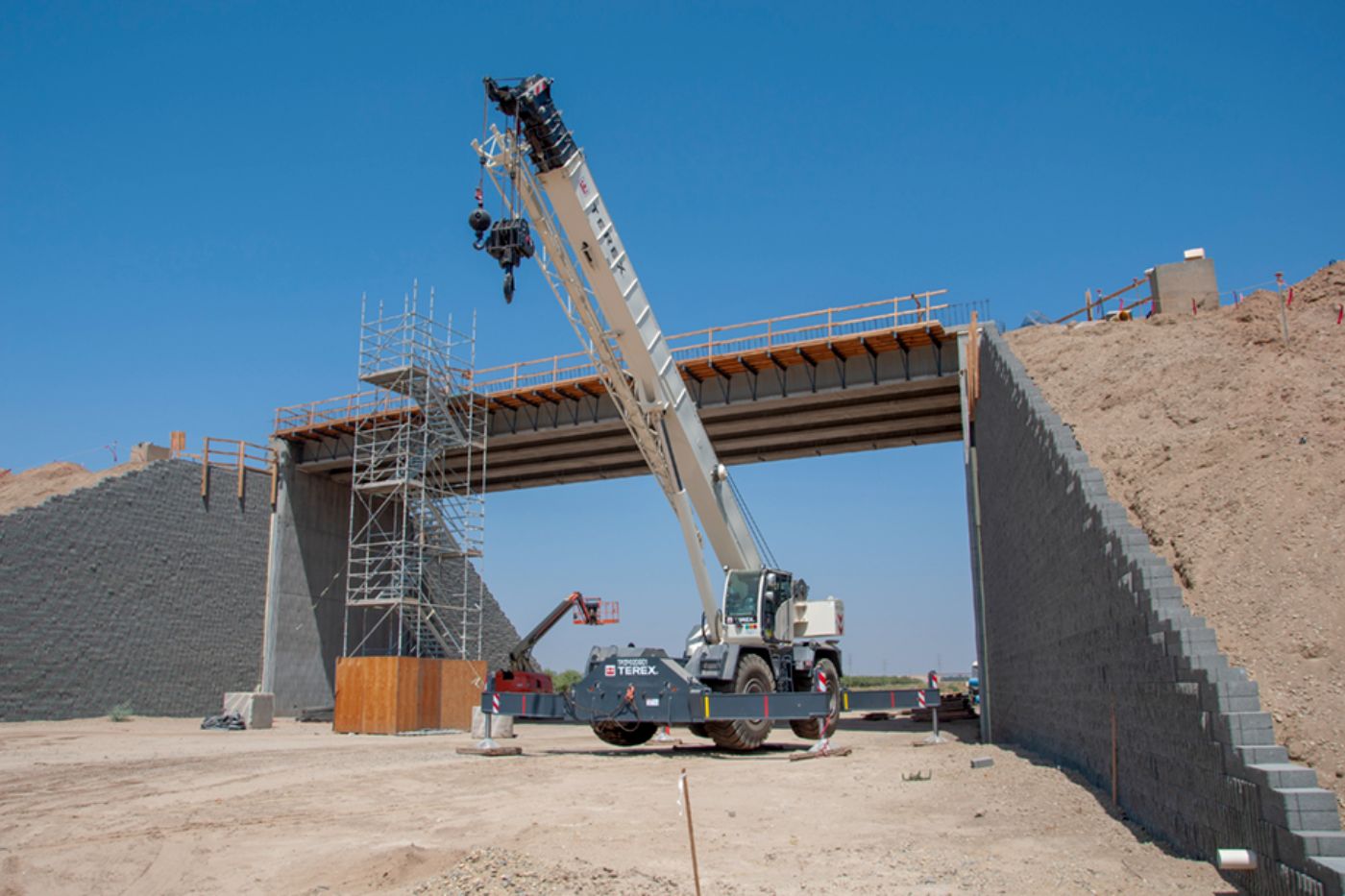

August 24, 2018

Also in Madera County, crews have constructed the bridge deck for the Avenue 11 overcrossing and are getting it ready for a concrete pour planned within the next few weeks. This crossing, east of Road 30 ½, will take traffic over the high-speed rail alignment.

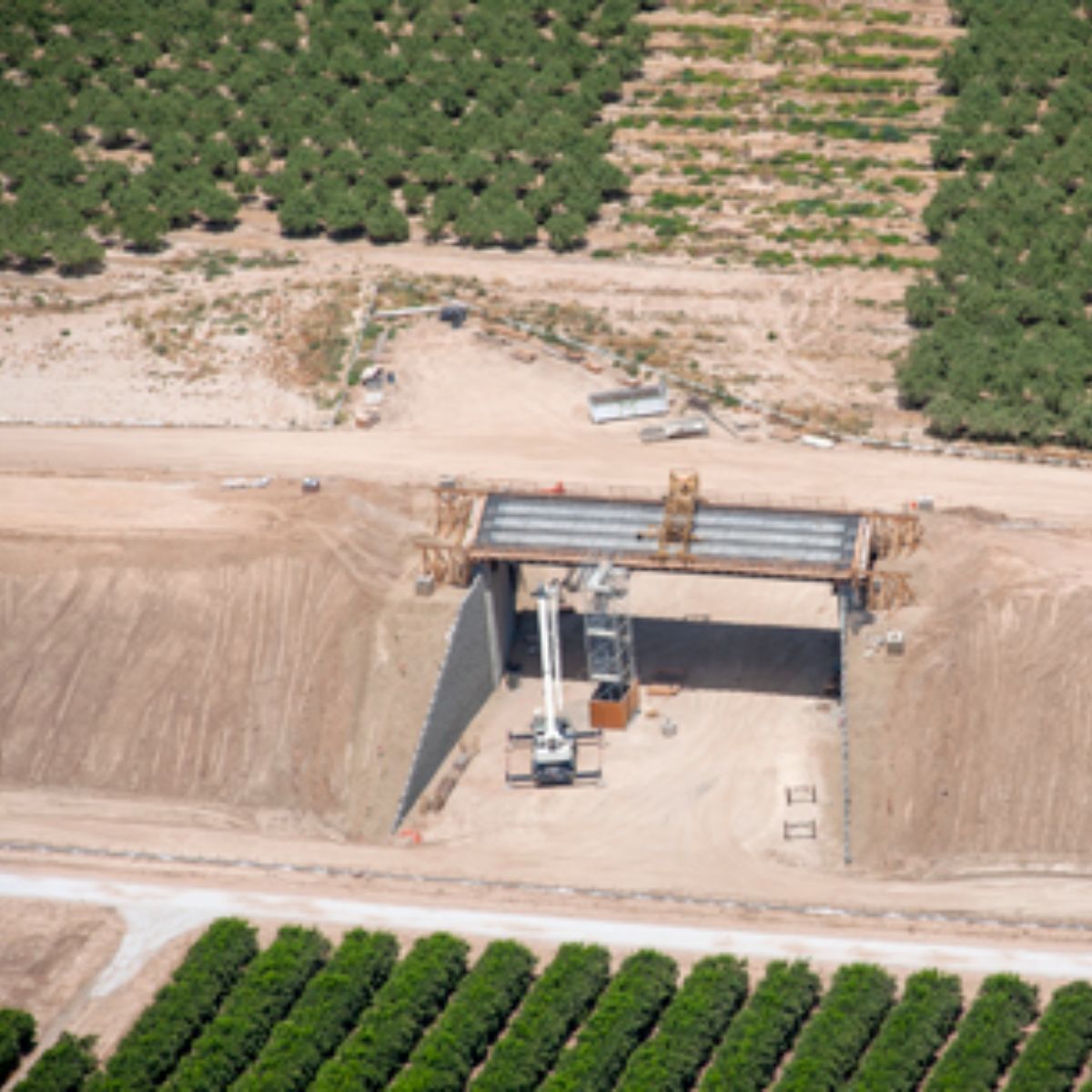

July 24, 2018

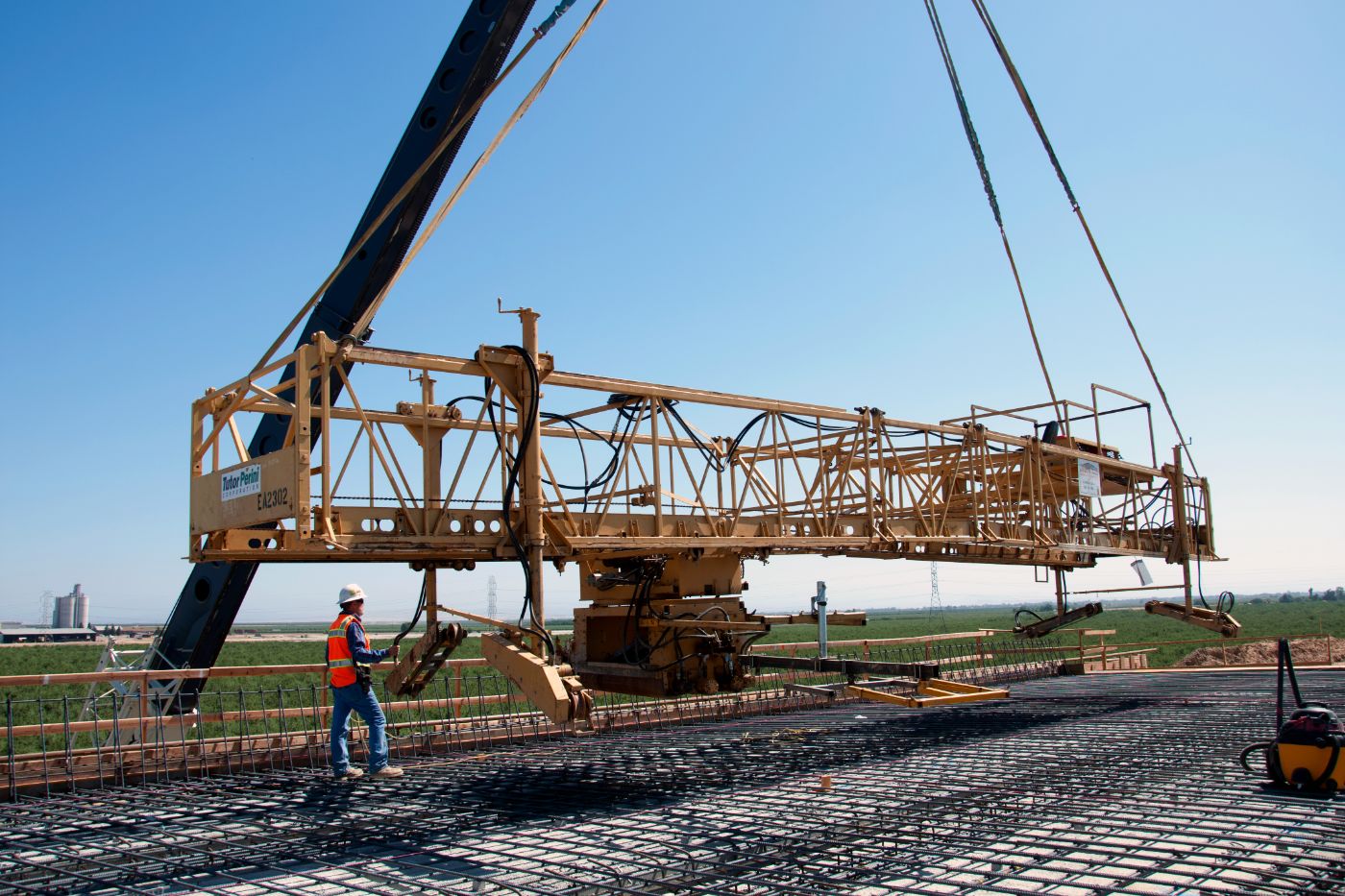

Also in Madera County, crews have constructed the bridge deck for the Avenue 11 overcrossing and are getting it ready for a concrete pour later in July. Pictured above, a crane lifts the paving machine, called a Bidwell, off the deck structure for some routine maintenance. This crossing, a little east of Road 30 ½, will take traffic over the high-speed rail alignment.

June 24, 2018

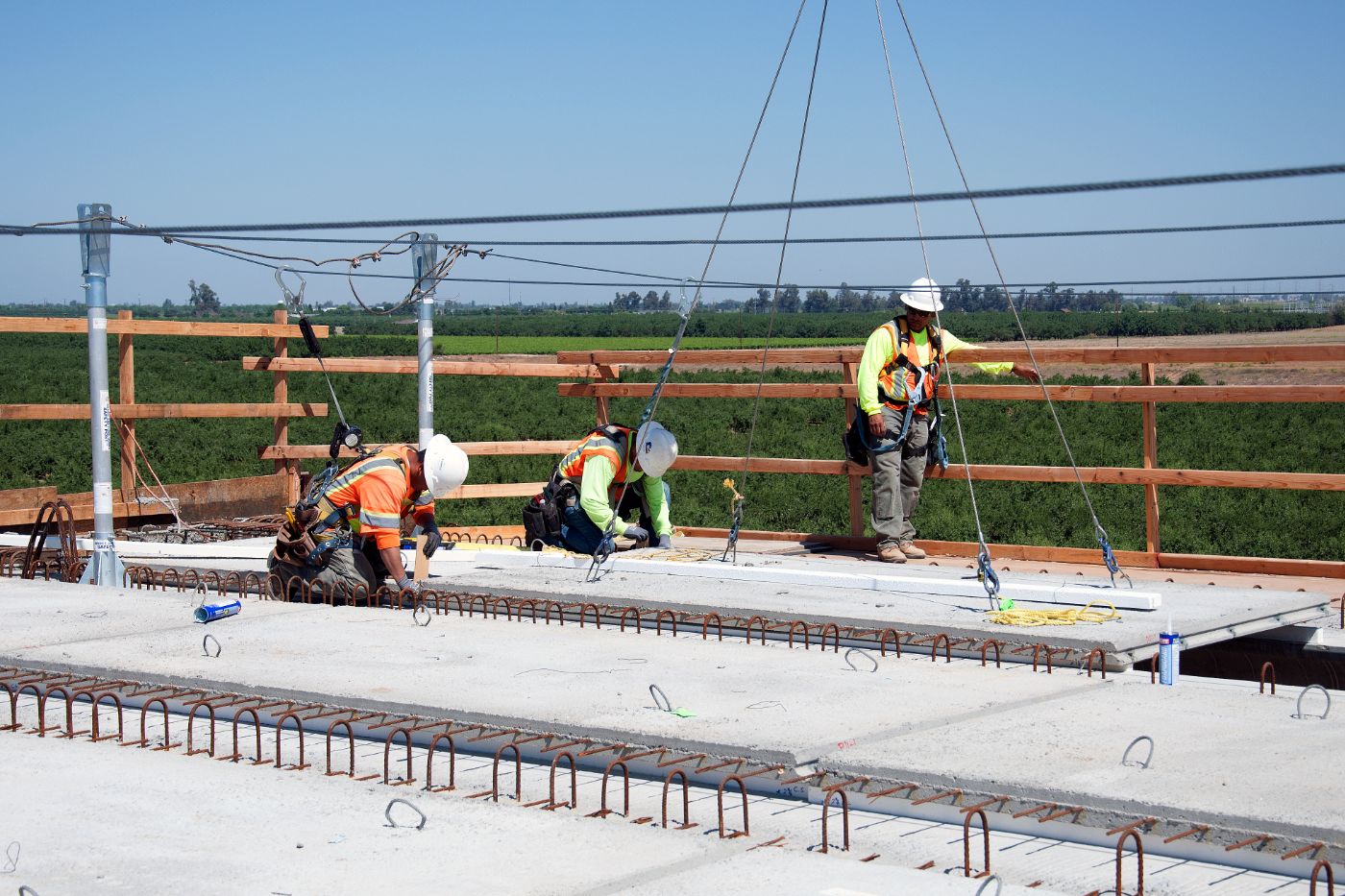

At Avenue 11, just east of Road 30 ½, the abutments for the overpass have been completed and bridge girders have been set. Crews are now beginning to form the bridge deck for this structure, which will take traffic over the high-speed rail alignment. A crane is seen lifting pre-cast concrete bridge deck panels onto the structure where they are carefully guided into place. Once the deck panels have been installed, the ironworkers will lay the deck steel. Next, carpenter and laborer crews will move in to form the edge of the deck and prepare for a concrete pour. Other crews have finished the block walls, which will retain the earthen embankment extending from the abutments.

May 24, 2018

With the abutments completed and bridge girders set, crews are about to begin forming the bridge deck for this structure which will take Avenue 11 traffic over the high-speed train alignment east of Road 30 ½ in Madera County. Other crews are now working on the mechanically stabilized earthen (MSE) block walls which will retain the earthen embankment extending from the abutments.

April 24, 2018

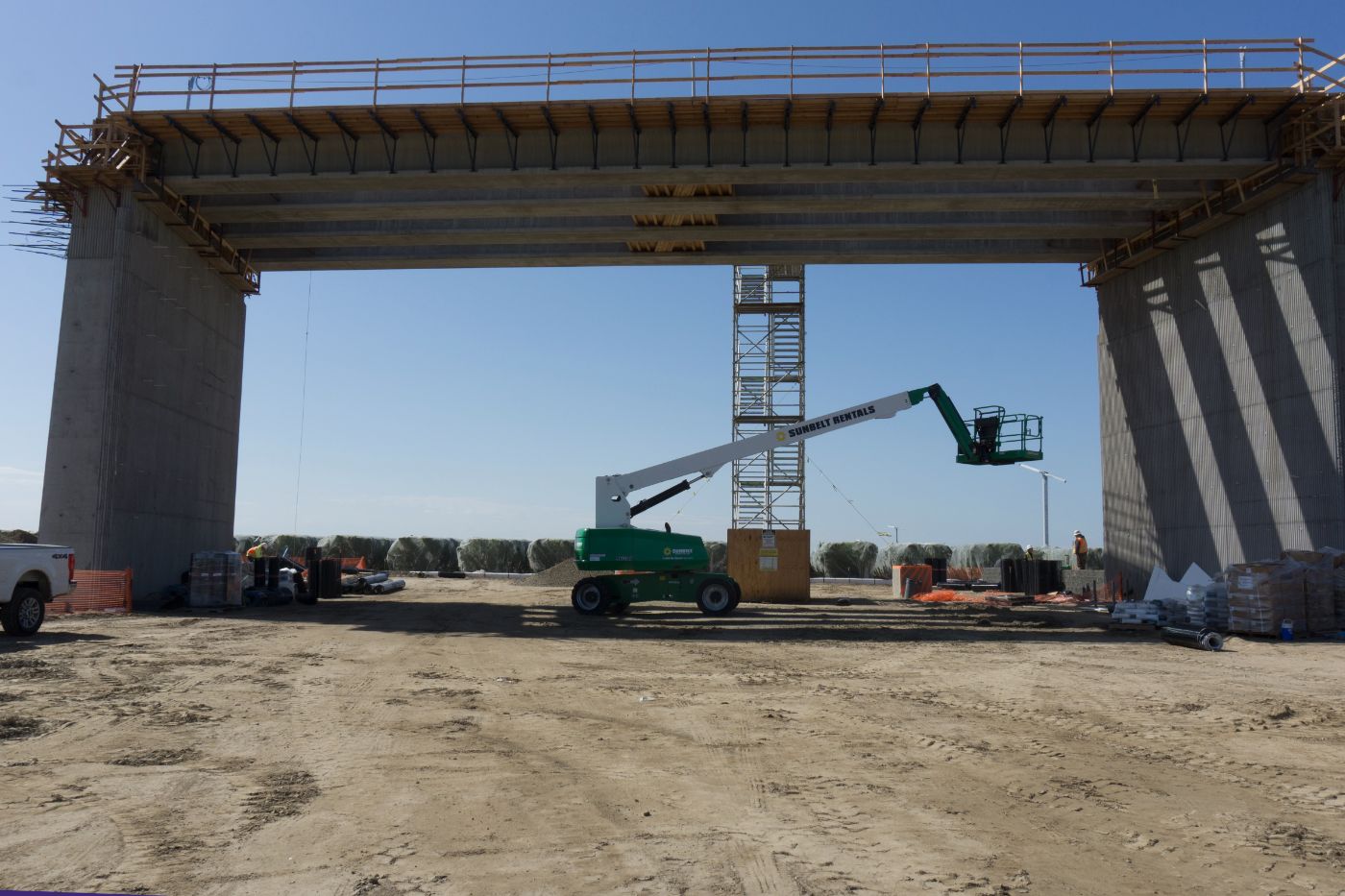

With the east and west abutments complete, girders have now been set for this single span crossing. Crews are now working on the bridge deck for the structure that will take Avenue 11 traffic over the high-speed train alignment east of Road 30 ½ in Madera County. Crews have installed overhang and handrails on the exterior of the girders to enable workers to access the superstructure of the bridge.

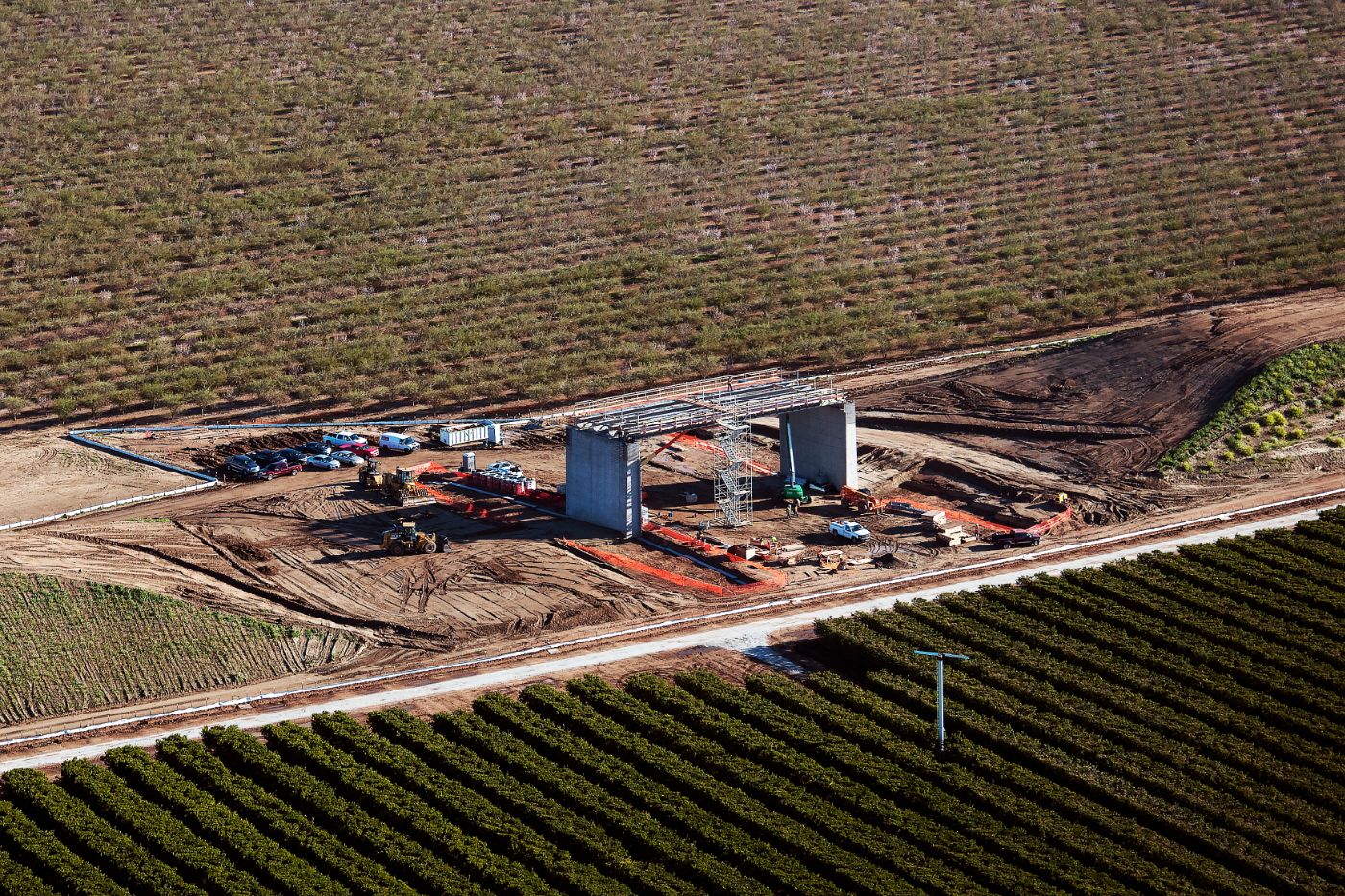

March 21, 2018

The east and west abutments have been poured for this single span bridge which will cross over the high-speed train alignment. Crews have begun to strip the abutment forms. Fill dirt has also been placed to on either side of the structure which will take traffic over the high-speed line east of Road 30 ½ in Madera County. Next, the site will be graded and prepared for girders to be landed on the structure.
